Balmoral Water Storage Facility

Water storage will provide reliability to enable farmers to meet the challenges of climate change and increased environmental flows in the Hurunui and Waiau Rivers. A new up to 10Mm3 storage pond is proposed, fed from the Hurunui River via the Balmoral scheme using existing consents. Water storage will allow farmers to be more resilient in the face of climate change, future proof their farming businesses and provide certainty for continued investment in local agribusinesses and the community. High reliability of water supply is critical in allowing our farmers to diversify their land use into other high value food production in the area.


Why do we need a storage facility?

The Balmoral Scheme irrigates approximately 8,000ha of land within the Hurunui catchment and currently delivers a good level of reliability for Amuri Irrigation Company (AIC) shareholders. However, when the Hurunui-Waiau River Regional Plan (HWRRP) became operable in 2013, it introduced higher environmental flows for both the Waiau and Hurunui Rivers.

Increased minimum flows will have significant implications on AIC’s current reliability of supply and further increases are likely in the future. These will limit AIC from taking water when the river is running at lower flows and introduce greater irrigation restrictions during the season.

The Balmoral Water Storage Facility (BWSF) is intended to mitigate the loss of run-of-river reliability, by adding a major source of pumped storage. The BWSF can also supplement the Waiau Scheme. AIC has modelled the financial impact on farmers and believes that the cost of constructing the storage facility is more than offset by the value in retaining a reliable supply of water. Higher reliability creates options for future land use diversity and will be critical for farmers considering moving from pastoral farming into higher value crops. The BWSF is expected to be bulk filled predominantly during winter and the irrigation shoulder seasons (August-October and April-May annually). Water not used for irrigation during the peak season (November-March) will be used to refill the BWSF, pending availability and flow restrictions.

The tables below show the different levels of reliability of the AIC schemes under current consent conditions, HWRRP minimum flows and HWRRP minimum flows with the BWSF.

AIC SCHEMES RELIABILITY - CURRENT CONSENTS

MINIMUM FLOWS (CUBIC METRES PER SECOND)


Project Location

A map of the proposed location of the BWSF

PROPOSED BALMORAL WATER STORAGE FACILITY SITE

A map of the proposed site layout of the BWSF

PROPOSED SITE LAYOUT


What are we Planning?

We propose constructing the Balmoral Water Storage Facility on a site adjacent to Tekoa Road and the existing Balmoral irrigation race within the Balmoral Forest, approximately 19km southwest of Culverden on land owned by Ngāi Tahu Farming.

The site is located on an upper alluvial terrace in the Balmoral Forest which gently falls in a SE direction. Currently the site is partially covered in exotic pine forestry plantation and the remainder in pine slash and exotic weed vegetation. The total site area affected by the BWSF is 134ha. The storage facility embankment footprint is 92ha. Proposed dimensions for the storage facility are 800m wide by 1,100m long (surface area 0.79km2). 10Mm3 is the upper limit for size. Consents will be pursued for a 10Mm3 pond, with the final size determined with pricing from the Contractor. This decision will depend on the appetite for storage from farmers; assessments of future climate change and land use opportunities; construction and funding costs.

Specifications:


Investigations

The design has considered a wide variety of factors.

A Lidar hillshade map showing active and possible faults near the BWSF site

LIDAR HILLSHADE MAP WITH ACTIVE FAULTS AND ‘POSSIBLE’ FAULTS (BOTH SHOWN AS RED LINES) MAPPED BY LITCHFIELD ET AL (2017)

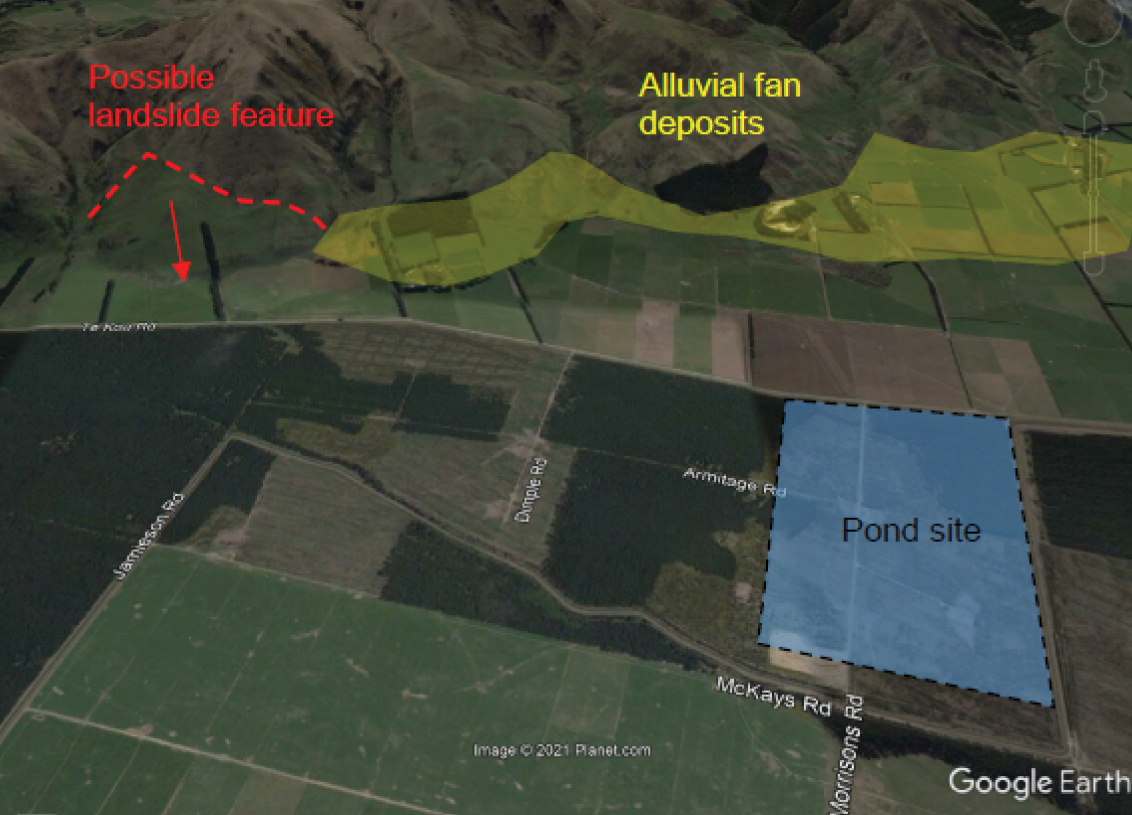

A map showing landslide features and alluvial fan deposits near the BWSF site

POSSIBLE ANCIENT LANDSLIDE FEATURE AND ALLUVIAL FAN DEPOSITS

Indicative Project Programme

  • 2023-2025 >

    Drafted and submitted Resource Consent applications to Environment Canterbury. Engaged with Stakeholders.

  • Mid 2025 >

    Resource Consent publicly notified.

  • Late 2025 >

    Detailed Design complete. Construction documents to Contractor for pricing. Consents issued.

  • Mid-2026 >

    Award Construction Contract.

  • Mid-2026 >

    Commence Construction.

  • Early 2029 >

    Construction Complete. Storage facilities filled and commissioned.

Effects during Construction

Construction of the BWSF will take place over a long period of time. We have considered how construction work may affect neighbouring properties. A Construction Management Plan (CMP) will be prepared which will outline the controls we intend to put in place to mitigate any impact from factors such as traffic movements, dust, noise and the visual impact.

An image of the Balmoral Forest looking down on the BWSF site

BALMORAL WATER STORAGE FACILITY SITE

An image of pine trees and native vegetation along the edge of the BWSF site

PINE BUFFER AND NATIVE VEGETATION TO BE REINSTATED


Dam Break Assessment

Large dams, like other pieces of major infrastructure (such as buildings and bridges) are designed on the basis that the higher the consequences of failure, the higher the design standards and performance requirements for the structure. The BWSF’s design, performance, construction and operational safety assurance criteria must be undertaken in accordance with the NZ Dam Safety Guidelines (2015).


Who can I contact about this Project?
